Transformer Replacement · Brownfield Transformer Decision Guide

The Repair Quote Looked Cheaper—Until the Transformer Had to Be Paid for Twice

Published July 26, 2026 · Prepared by the TransformerGrid technical editorial team · Project-specific requirements require manufacturer, utility and applicable-standard verification.

Start with the parent decision guide: Pole Mounted vs Pad Mounted Transformer: Cost and Application Guide. This article addresses one brownfield replacement decision in greater depth rather than repeating the general comparison.
Technical engineering reference: Transformer Refurbishment Scope and Acceptance Testing: Inspection, Drying, Oil Treatment and Rewinding. Use the Technical Library page for neutral engineering scope, acceptance criteria and compatibility checks before applying this buying guide.

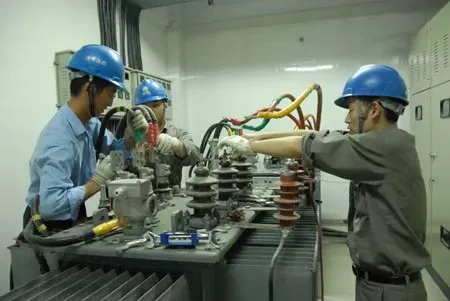

Inspection of an oil-immersed transformer before deciding whether a limited repair, full refurbishment or replacement is technically justified.
Inspection of an oil-immersed transformer before deciding whether a limited repair, full refurbishment or replacement is technically justified.

A repair quotation can look like the fastest way out of a transformer problem. It may be 30%, 40%, or even 50% lower than a new unit. The equipment is already on site. The mounting arrangement is familiar. The buyer hopes the outage can be shortened by restoring what already exists.

Then the scope begins to expand.

The tank must be drained. The transformer has to be removed from the pole. Freight is required in both directions. Oil tests reveal moisture. Internal inspection finds aged paper insulation. Bushings and gaskets are no longer standard. The rewind schedule is longer than expected. A second rental generator is needed. The “repair” becomes a sequence of separate costs, each approved after the first quotation was accepted.

The original repair price was not necessarily dishonest. It was simply answering a smaller question than the project actually asked.

The scenario in this article combines common procurement and maintenance problems. It is not presented as a single named customer order.

Repair, Refurbishment, Rewinding and Replacement Are Not the Same Decision

Refurbishment and new replacement follow different cost, discovery, warranty and standardization paths.
Refurbishment and new replacement follow different cost, discovery, warranty and standardization paths.

These terms are often used as if they were interchangeable. They are not.

Field repair

Field repair normally addresses an accessible defect without rebuilding the active part. Examples may include replacing an external bushing, repairing a leak, changing a gauge, correcting a loose connection, or replacing an accessory.

Field repair can be sensible when the defect is isolated, the transformer has a known service history, and the internal insulation system remains healthy.

Factory refurbishment

Refurbishment may include draining and filtering oil, replacing seals, repairing the tank, cleaning the active part, replacing bushings and accessories, repainting, drying, retesting, and restoring the unit for service.

The exact scope varies widely. A quotation that says “complete refurbishment” should still list every included inspection, material, test and warranty condition.

Rewinding

Rewinding is a deeper intervention. The core-and-coil assembly is opened, the old winding is removed, new conductors and insulation are installed, and the transformer is dried, reassembled, filled and tested.

Rewinding may preserve a special mechanical footprint or unusual voltage design. It can also expose the buyer to long lead time, uncertain findings after disassembly, and a warranty that may not equal a new transformer warranty.

New replacement

A new transformer allows the buyer to reassess capacity, voltage, BIL, taps, losses, protection, corrosion resistance, accessories, documentation and future load instead of automatically repeating the old design.

The purchase price may be higher, but the project scope is usually easier to define before the order.

The Seven Questions That Should Decide the Path

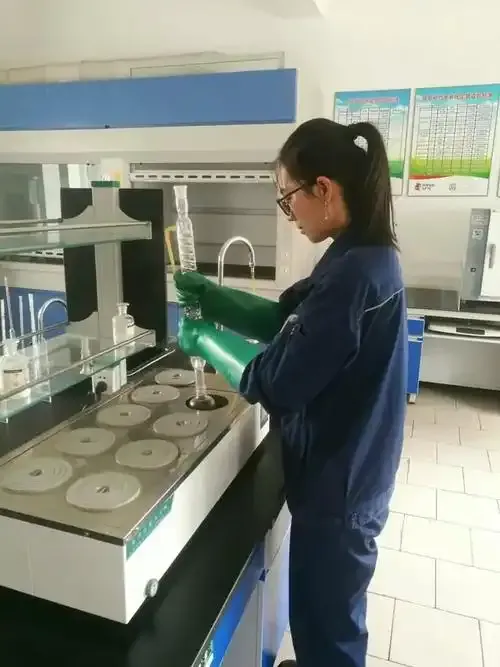

Oil moisture, acidity, breakdown voltage and DGA evidence help determine whether the active part still deserves further investment.
Oil moisture, acidity, breakdown voltage and DGA evidence help determine whether the active part still deserves further investment.

1. Is the failure isolated or systemic?

An external leak, damaged arrester or cracked bushing may be repairable. Repeated overheating, abnormal dissolved gases, carbonized insulation, winding deformation or multiple internal faults suggest a larger ageing problem.

2. What is known about the insulation condition?

The tank and paint can be restored. The more difficult question is the condition of the cellulose insulation around the winding. Once paper insulation has lost mechanical strength, a cosmetic refurbishment cannot restore it.

Useful evidence may include:

3. Is the old rating still correct for the load?

A like-for-like rewind may reproduce a transformer that was already overloaded. The buyer should review connected load, motor starting duty, future expansion, ambient temperature and actual load profile before paying to restore the old kVA.

4. Are the voltage and utility requirements still current?

The local network may have changed. Protection settings, grounding practice, nameplate requirements, loss limits or documentation expectations may be different from those in force when the old unit was purchased.

5. Is the old mechanical arrangement worth preserving?

A special mounting bracket, pole geometry, bushing location or conductor arrangement can make an exact mechanical replacement valuable. However, preserving the footprint should not override electrical safety or future compatibility.

6. What is the real outage schedule?

A repair shop may quote a shorter production period, but the total schedule must include removal, draining, transport, inspection, approval of findings, material procurement, repair, drying, testing, return freight, lifting and recommissioning.

7. What warranty and evidence will be delivered?

The buyer should compare more than warranty length. Confirm what is covered, what testing will be performed, which values will be recorded, what parts remain original, and who is responsible if the unit fails acceptance testing.

Cost Comparison: What the First Quotation Often Leaves Out

Cost item Field repair Factory refurbishment Rewinding New replacement
Initial quoted work Low Medium Medium to high High
Removal and lifting Sometimes Usually Usually Usually
Two-way freight Rare Usually Usually No return freight
Oil handling and disposal Possible Common Common Usually included in factory scope
Unknown findings after opening Low Medium High Low
Design update opportunity Very limited Limited Moderate High
Warranty clarity Varies Varies Varies Usually clearer
Schedule certainty Medium Medium Low to medium Medium to high after approval
Ability to standardize future spares Low Low Moderate High

The cheapest line in this table is not automatically the cheapest project.

When Refurbishment Can Make Good Sense

Refurbishment deserves serious consideration when:

When New Replacement Is Usually the Stronger Decision

A new unit is often more defensible when:

Evidence to Request Before Approving a Refurbishment

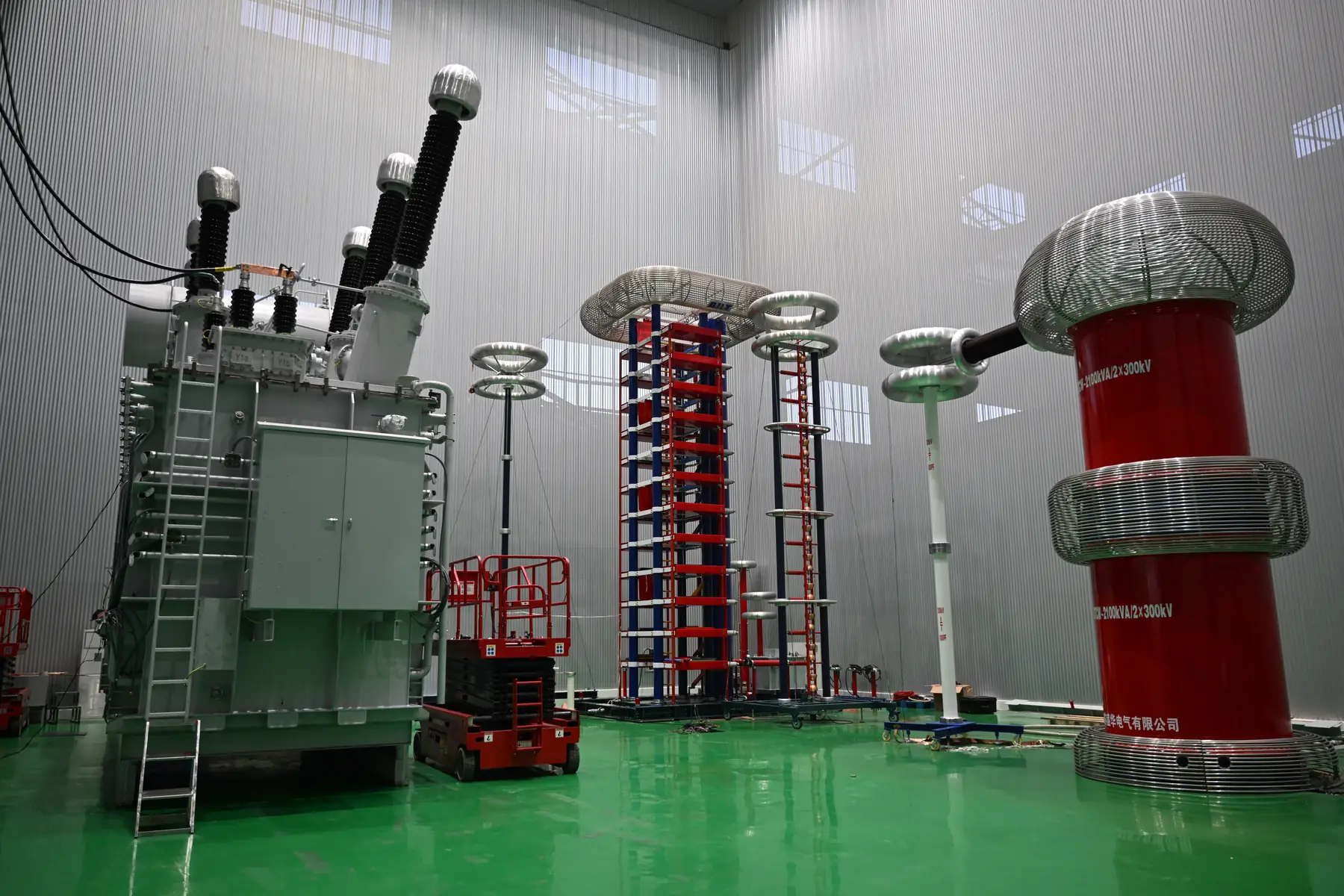

Factory test capability and clear acceptance evidence should be compared with the repair provider’s proposed post-work test plan.
Factory test capability and clear acceptance evidence should be compared with the repair provider’s proposed post-work test plan.

Ask the repair provider to state:

  1. the condition assessment method;
  2. parts to be reused;
  3. parts to be replaced;
  4. oil treatment or replacement scope;
  5. drying method;
  6. winding work, if any;
  7. tank repair and coating system;
  8. routine and special tests;
  9. acceptance limits;
  10. warranty exclusions;
  11. expected findings that could change the price;
  12. total schedule from removal to recommissioning.

Without this list, the buyer is comparing a detailed new-transformer quotation with an open-ended repair promise.

What to Send for a Replacement-Path Review

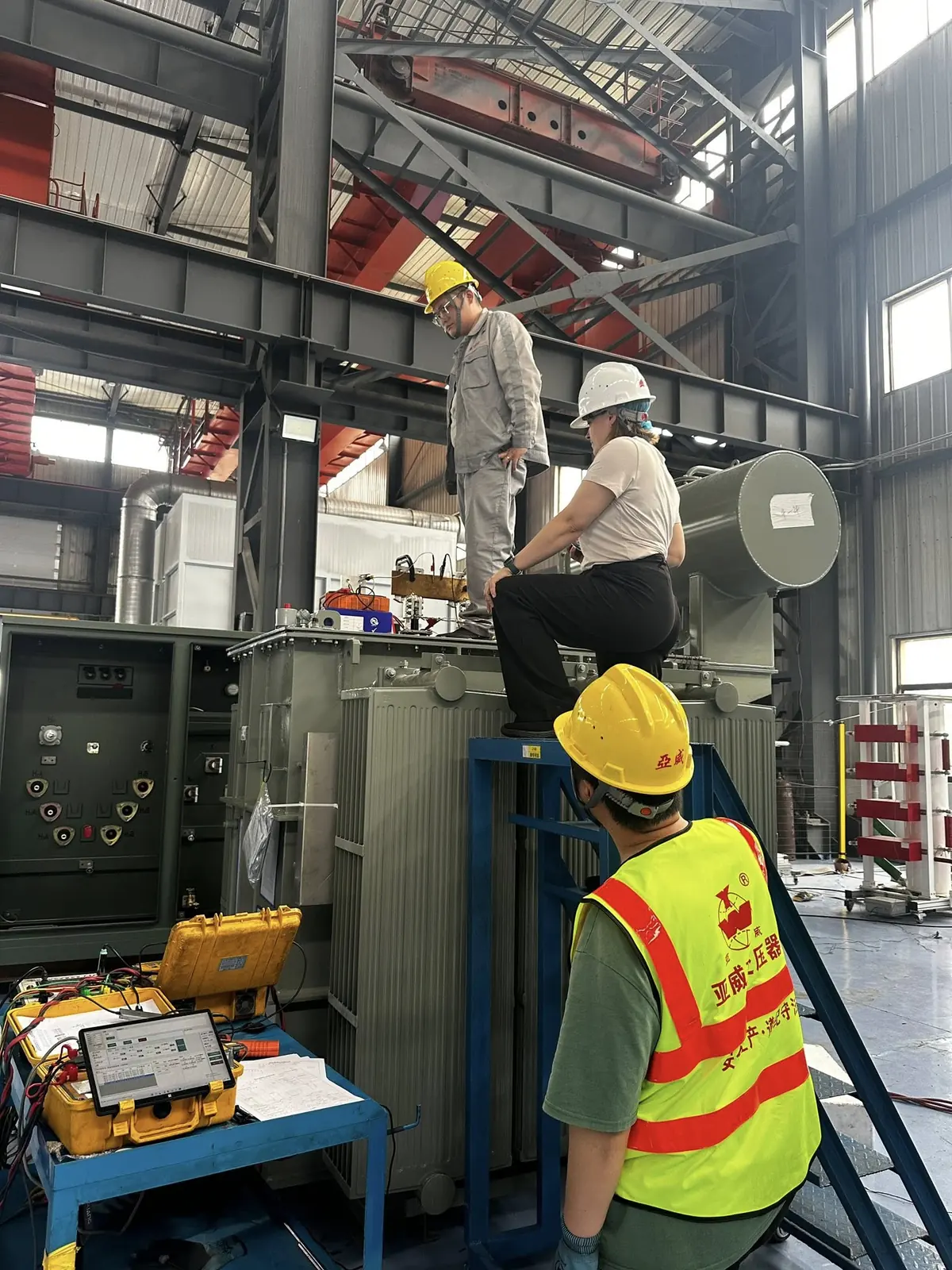

Technical review, drawings, test records and inspection evidence create a comparable basis for replacement procurement.
Technical review, drawings, test records and inspection evidence create a comparable basis for replacement procurement.

A useful review package includes:

TransformerGrid can help organize this information, identify open technical points, and coordinate a new-replacement quotation with a verified manufacturing partner. We do not present ourselves as the repair shop for every damaged unit. Our role is to help the buyer compare the repair path and the replacement path on the same technical and commercial basis.

Final Decision Rule

Do not ask only:

“Which option has the lower first quotation?”

Ask:

“Which option gives the clearest scope, acceptable outage risk, verifiable test evidence and lowest probability of paying for the same problem twice?”

FAQ

Is a refurbished pole-mounted transformer always less reliable than a new unit?

No. A properly assessed and competently refurbished transformer can provide useful service. The risk rises when the internal condition is unknown, the scope is vague, or the unit is being restored to an outdated or overloaded design.

Is rewinding faster than buying new?

Sometimes, but not automatically. The total schedule includes disassembly, inspection, material availability, drying, testing and transport. A standard new unit may be faster when manufacturing slots and design approval are available.

What test reports should be requested after refurbishment?

The test plan should match the repair depth and applicable standard. Common checks may include ratio, winding resistance, insulation resistance, losses, impedance, dielectric tests, oil tests and leak or pressure checks.

Can TransformerGrid quote a new replacement from an old nameplate?

An old nameplate is a useful starting point. A responsible quotation should also confirm present load, voltage, site conditions, protection, utility requirements and the cause of the original failure.


Send the Existing Condition Before Requesting a Quote

Share the old nameplate, drawings, site photos, current load, failure history, utility requirements and required delivery date. TransformerGrid can help organize open technical points and coordinate quotation, drawings, documents, FAT and export delivery with a verified manufacturing partner.
