Cost & Procurement · Brownfield Transformer Decision Guide

The Transformer Is Only One Line in the Replacement Bill

Published July 26, 2026 · Prepared by the TransformerGrid technical editorial team · Project-specific requirements require manufacturer, utility and applicable-standard verification.

Start with the parent decision guide: Pole Mounted vs Pad Mounted Transformer: Cost and Application Guide. This article addresses one brownfield replacement decision in greater depth rather than repeating the general comparison.
Technical engineering reference: Transformer Replacement Outage and Commissioning Plan: Temporary Power, Testing and Energization. Use the Technical Library page for neutral engineering scope, acceptance criteria and compatibility checks before applying this buying guide.
Transformer replacement cost has five layers: equipment, removal, installation, testing and downtime.
Transformer replacement cost has five layers: equipment, removal, installation, testing and downtime.

A buyer may compare two transformer quotations and choose the lower one. The project team may still exceed its budget because neither quotation includes the full replacement scope.

The equipment invoice is visible. The rest of the cost often appears later:

The transformer price matters. The replacement project price determines whether the budget survives.

The cost scenario in this article is a composite of common replacement projects. It is not a quotation for a specific site.

Five Layers of Replacement Cost

Layer 1: New Equipment

The supply price may include:

A low equipment price may exclude accessories or documents that another supplier includes. The comparison must use the same scope.

Layer 2: Removal of the Existing Unit

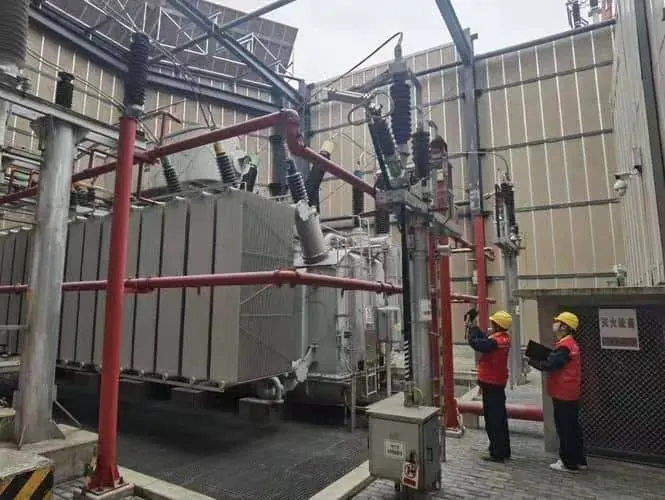

Removal planning includes safe isolation, lifting access, oil handling, old-equipment transport and disposal responsibilities.
Removal planning includes safe isolation, lifting access, oil handling, old-equipment transport and disposal responsibilities.

Removal costs may include:

Pole-mounted and pad-mounted removals use different equipment, but both can become expensive when access is poor or the outage window is narrow.

Layer 3: Installation and Site Work

Pole-mounted replacement

Possible costs include:

Pad-mounted replacement

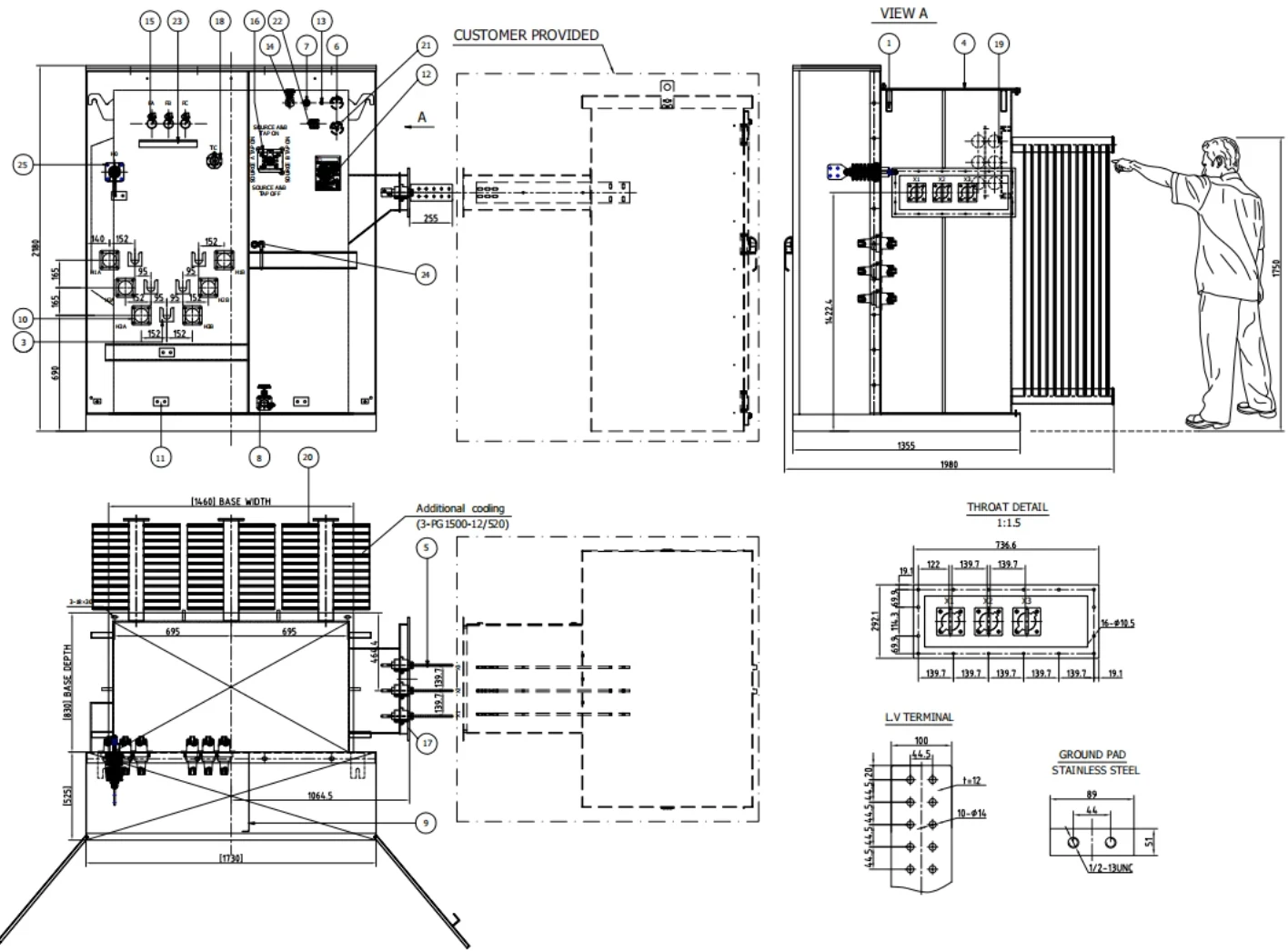

Pad-mounted replacement can require foundation, opening, cable-route and dimensional interface verification.
Pad-mounted replacement can require foundation, opening, cable-route and dimensional interface verification.

Possible costs include:

Pole-to-pad conversion

Conversion can include both sets of costs plus overhead-to-underground transition work.

Layer 4: Testing, Approval and Commissioning

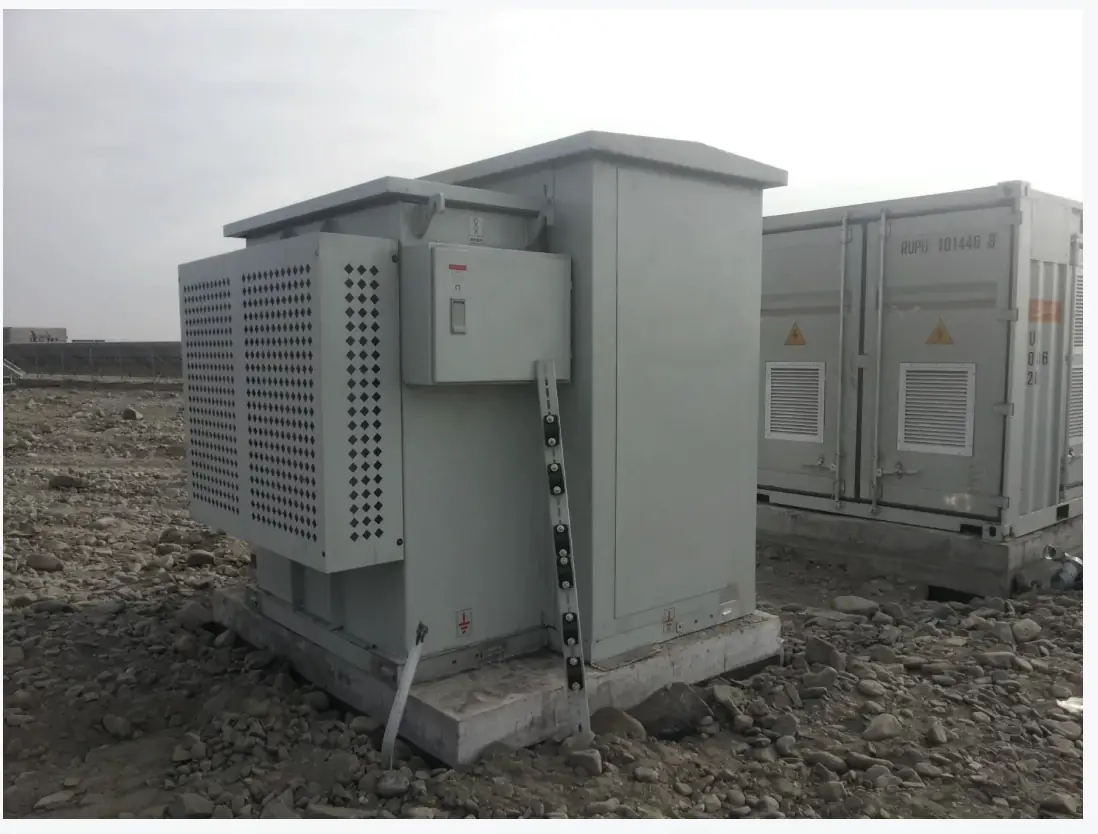

Site testing, grounding review, commissioning and utility approval should be included in the replacement budget.
Site testing, grounding review, commissioning and utility approval should be included in the replacement budget.

Budget for:

Documentation delays can be as real as manufacturing delays. Drawings, nameplate data and test reports should be agreed before shipment.

Layer 5: Time and Downtime

Temporary power, emergency planning and contractor coordination may cost more than the apparent equipment saving.
Temporary power, emergency planning and contractor coordination may cost more than the apparent equipment saving.

Downtime can exceed the transformer price when the load supports:

Time-related costs may include:

Comparative Budget Framework

Pole replacement, pad replacement and pole-to-pad conversion have different civil, cable and interface cost profiles.
Pole replacement, pad replacement and pole-to-pad conversion have different civil, cable and interface cost profiles.
Cost item Pole-for-pole replacement Pad-for-pad replacement Pole-to-pad conversion
Transformer supply Medium Medium to high Medium to high
Pole / overhead hardware Medium Low Medium for transition
Concrete / civil work Low Medium High
MV cable and terminations Low Medium High
Lifting equipment Bucket truck or crane Crane or forklift May require both
Utility coordination Required as applicable Required as applicable Usually more complex
Outage duration Often shorter when like-for-like Moderate Often longest
Temporary power need Project-dependent Project-dependent More likely for staged work
Approval risk Lower if unchanged Moderate Higher because interfaces change
Future maintenance access Elevated Ground level Ground level after conversion

The table is a budgeting framework, not a fixed price list. Site conditions and local requirements control the final cost.

The Second-Mobilization Trap

Many replacement budgets fail because one missing interface is discovered after the contractor leaves.

Examples:

A second crane, second crew and second shutdown can cost more than the original equipment-price difference.

How to Build a Replacement Budget Before Ordering

Step 1: Separate supply and site scopes

Create distinct lines for transformer supply, removal, civil work, cable work, utility work, testing, commissioning and temporary power.

Step 2: Identify ownership boundaries

Clarify which equipment belongs to the utility, owner, landlord, EPC or contractor.

Step 3: Confirm interface dimensions

Review pole mounting, pad dimensions, cable-entry direction, bushing location, terminal type, conductor size, weight and clearances.

Step 4: Price the outage

Estimate generator cost, operational loss, contractor standby and contingency days.

Step 5: Include schedule risk

A cheaper transformer with a longer or less certain delivery may not be cheaper for a critical replacement.

What to Send for a More Complete Quotation

TransformerGrid can coordinate the equipment scope, drawings, technical clarifications, factory documentation, FAT requirements and export delivery with verified manufacturing partners. Local removal, civil work, installation and utility connection must be priced and executed by qualified local parties.

Final Decision Rule

Do not select a replacement transformer until the project team can answer:

“What will we spend from the first shutdown instruction to final energization?”

That number, not the transformer invoice alone, is the true replacement cost.

FAQ

Why can installation cost more than the transformer?

Civil work, cable, lifting, outage coordination, temporary power, utility work and contractor mobilization can exceed equipment cost, especially in conversions or difficult-access sites.

Is pole-mounted replacement always cheaper than pad-mounted replacement?

Not always. Pole-mounted equipment may have lower enclosure and civil cost, but access, pole condition, overhead work and outage constraints can change the result.

Should freight be included in replacement cost?

Yes. Compare the Incoterm and include inland transport, unloading, rigging, insurance, customs and site delivery where applicable.

How can buyers reduce replacement cost risk?

Confirm interfaces early, separate scopes, approve drawings before production, define required tests and documents, and build an outage plan with contingency.


Send the Existing Condition Before Requesting a Quote

Share the old nameplate, drawings, site photos, current load, failure history, utility requirements and required delivery date. TransformerGrid can help organize open technical points and coordinate quotation, drawings, documents, FAT and export delivery with a verified manufacturing partner.

Send RFQ and drawingsPole-mounted transformerPad-mounted transformer
